Updated Jul. 15, 2026

Google Columbus

Columbus, Ohio, United States

Google Columbus is an operational AI data center hosting an estimated 409k H100-equivalent chips, scaling toward a projected 707k H100-equivalent chips — supported by 303 MW of IT power, rising to 386 MW — at a capital cost of $11.5 B, rising to $14.6 B. We estimate that it uses Google TPU v5e, Google TPU v5p, Google TPU v6e, and Google TPU v7 chips. The timeline of IT power and compute capacity is based on satellite imagery, our cooling equipment power model, regulatory filings, chip efficiency, and chip availability.

OWNER Google STATUS Operational USER Google DeepMind
Show compute as
Satellite view of Google Columbus

Satellite imagery

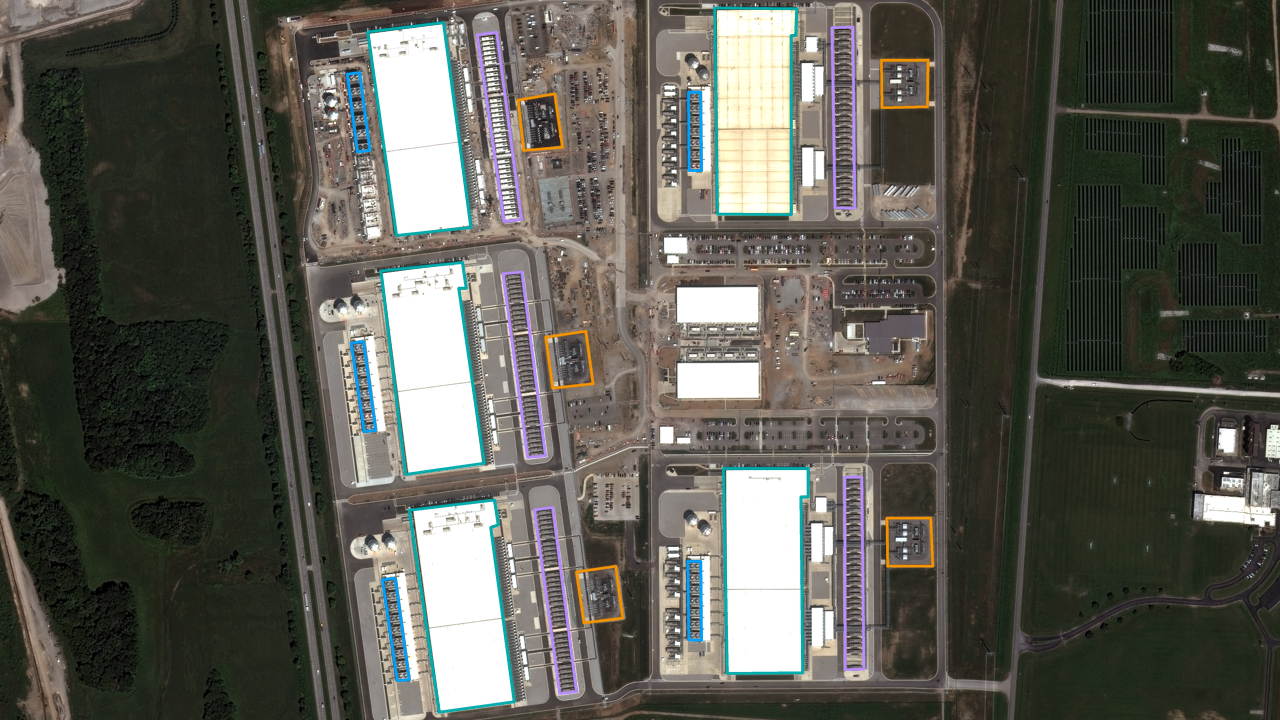

Latest: Feb. 27, 2026 · 1 high-res images
View satellite explorer →

Scale & specifications

CURRENT COMPUTE

409k H100-eq

8.09e20 8-bit OP/s

PROJECTED

707k H100-eq

1.40e21 8-bit OP/s

CURRENT IT POWER

303 MW

PROJECTED IT POWER

386 MW

CURRENT COST

$11.5 B

PROJECTED COST

$14.6 B

HardwareGoogle TPU v5e, Google TPU v5p, Google TPU v6e, Google TPU v7

CoolingEvaporative cooling tower

Buildout

Oct 1, 20210K H100e
Oct 1, 2021

Land clearing begins on the eastern half of the site, for Buildings 1-2

Jul 1, 2023

Building 2 foundation work begins. Building 1 generators seem complete, cooling towers still under construction.

Apr 1, 2024

Building 1 operational. No visible construction and roads/parking complete around the building. Building 2 chillers are beginning construction. Foundation work begins for Building 3.

Compute
33kH100-eq
IT Power
65MW
Cost
$2.5B
Mar 1, 2025

Building 2 operational. Parking complete, no more visible construction.

Compute
112kH100-eq
IT Power
130MW
Cost
$4.9B
Oct 1, 2025

Building 3 operational. Surrounding roads finished, no more visible construction.

Compute
233kH100-eq
IT Power
216MW
Cost
$8.2B

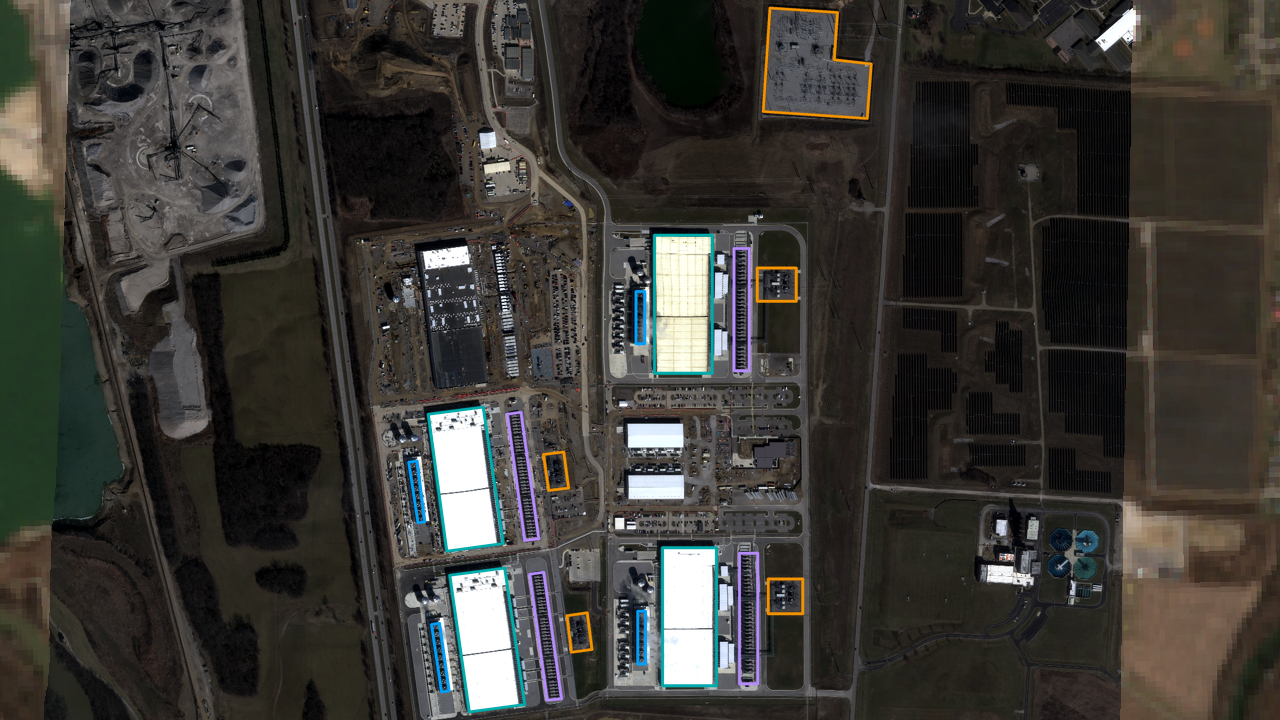

Feb 21, 2026

Buildings 1-3 are visibly operational, with steam coming out of the cooling towers. Meanwhile Building 4 is extremely close to completion, with all backup generators complete with only 3 cooling towers missing their fans. ~1/2 the generators are installed for Building 5, and the roof is mostly complete (starting to install the final white layer, with the actual roof structure already complete).

Compute
233kH100-eq
IT Power
216MW
Cost
$8.2B
May 1, 2026

Building 4 operational. No more visible construction, and since only 3 fans needed to be installed since Feburary, operational date was likely soon after. Building 5 roof almost complete.

Compute
409kH100-eq
IT Power
303MW
Cost
$11.5B
Jul 1, 2027

Building 5 operational. The transmission line construction notice that expands site by 100 MW is assumed to be entirely for Building 5, and has an in-service date of July 1, 2027 (page 3). Estimate taken on the safe side based on completion times for Building 3-4 from when roof was complete.

Compute
707kH100-eq
IT Power
386MW
Cost
$14.6B

Sources

  1. DCD article detailing early work beginning on the site
  2. Transmission line construction notice; details current site capacity, expansion, and maximum future site capacity

Read more about our methodology.
