Meta Los Lunas

Los Lunas, New Mexico, United States

Meta Los Lunas is an operational AI data center with AI chips owned and used by Meta. It hosts an estimated 100k H100-equivalents of AI compute, supported by 87 MW of IT power at a capital cost of $3.3 B. In Q1 2028, we project it to rise to 869k H100e AI compute, 218 MW IT power and a cost of $8.3 B. We estimate that it uses Nvidia B300 chips.

The timeline of IT power and AI compute capacity is based on satellite imagery, our cooling equipment power model, chip availability, and chip efficiency.

OWNERMetaSTATUSOperationalUSERMeta
Show compute as
Satellite view of Meta Los Lunas

Satellite imagery

Latest: Jul. 29, 2026 · 2 high-res images
View satellite explorer →

Scale & specifications

CURRENT COMPUTE

100kH100e

1.97e208-bit OP/s

PROJECTED

869kH100e

1.72e218-bit OP/s

CURRENT IT POWER

87MW

PROJECTED IT POWER

218MW

CURRENT COST

$3.3B

PROJECTED COST

$8.3B

CoolingUnknown

Buildout

Jul 24, 20240K H100e
Jul 24, 2024

Land clearing starts for new building.

Mar 1, 2026

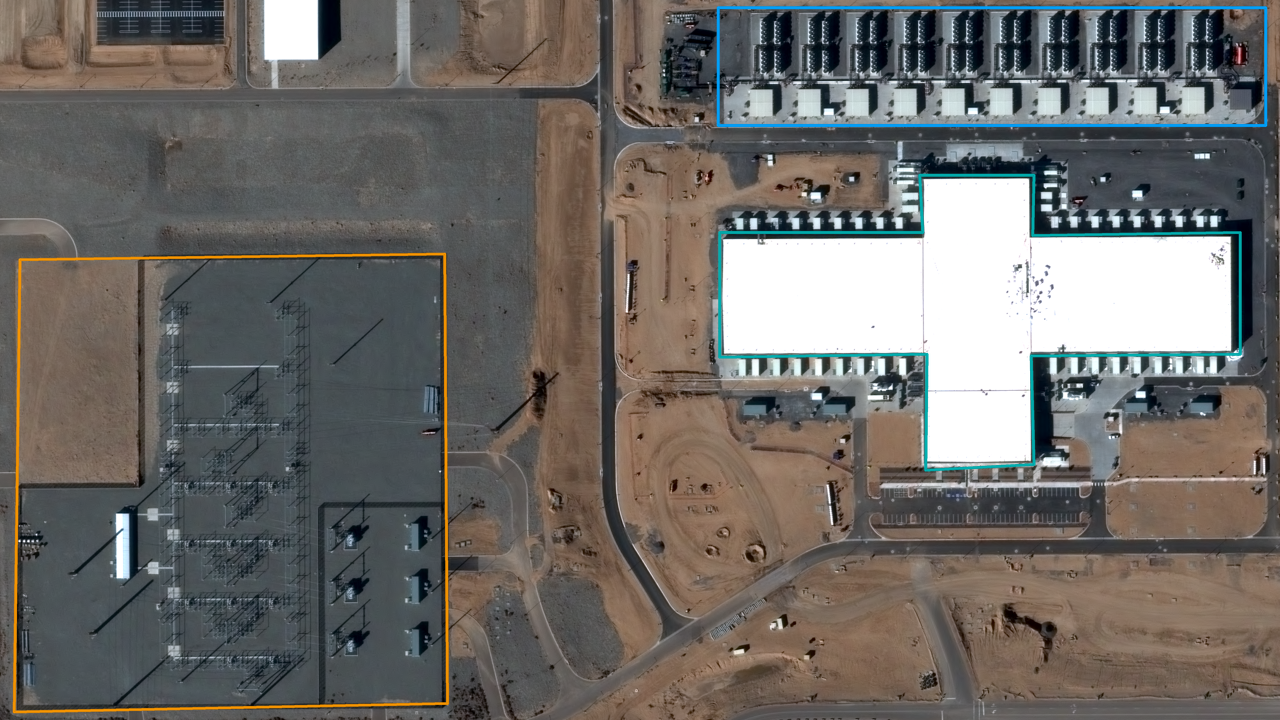

Building 1 is operational, based on no construction activity around the shell and cooling equipment, and about 5 months passing after structural completion.

Compute
100kH100e
IT Power
87MW
Cost
$3.3B

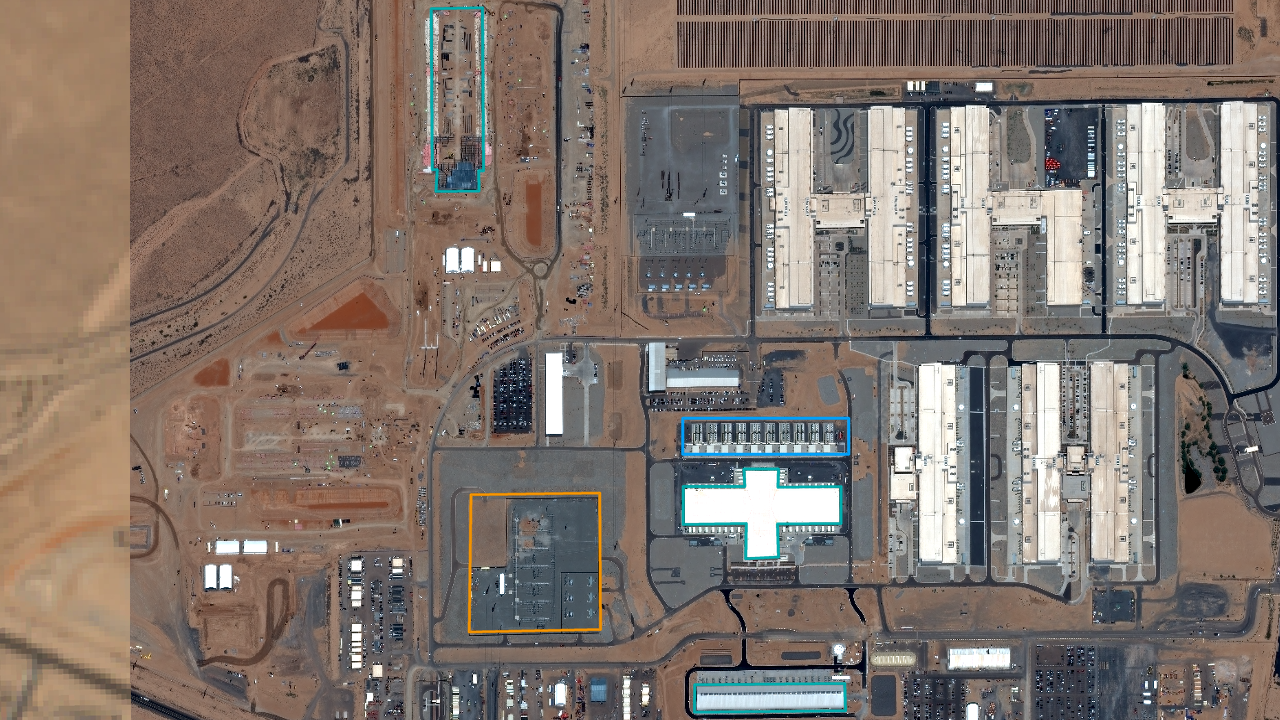

Jul 28, 2026

Building 2 (a tent-like building) shell is complete, but we don't believe it's operational because there is unpaved ground, no cars parked right in front, the first tent buildings at Meta Prometheus took about 16 months (it's been 10 months for this building). North-west of Building 1, the outline of a building of similar dimensions and style to Meta Jeffersonville's Building 1 is visible, this is labeled as Building 3. West of Building 1 we see more land clearing for what could be a building similar to Meta Jeffersonville's Building 2.

Compute
100kH100e
IT Power
87MW
Cost
$3.3B
Oct 26, 2026

Building 2 (a tent like building) is operational. Based on a default estimate of 3 months for fit-out after structural completion in July.

Compute
134kH100e
IT Power
118MW
Cost
$4.5B
Jan 1, 2028

Building 3 is estimated to be operational. This is estimated from the timeline of similar buildings at other Meta sites.

Compute
869kH100e
IT Power
218MW
Cost
$8.3B

Sources

  1. Meta fact sheet
  2. Air quality permit for expansion
  3. Construction contractor page for the site

View our calculations for this data center, or read more about our methodology.
