Updated Jul. 25, 2026

Google Mesa

United States

Google Mesa is an operational AI data center with AI chips owned by Google. It hosts an estimated 126k H100-equivalents of compute, supported by 90 MW of IT power at a capital cost of $3.4 B. In Q3 2026, we project it to rise to 343k H100-eq compute, 183 MW IT power and a cost of $6.9 B. We estimate that it uses Google TPU v6e chips.

The timeline of IT power and compute capacity is based on satellite imagery, our cooling equipment power model, chip availability, and chip efficiency.

OWNER Google STATUS Operational
Show compute as

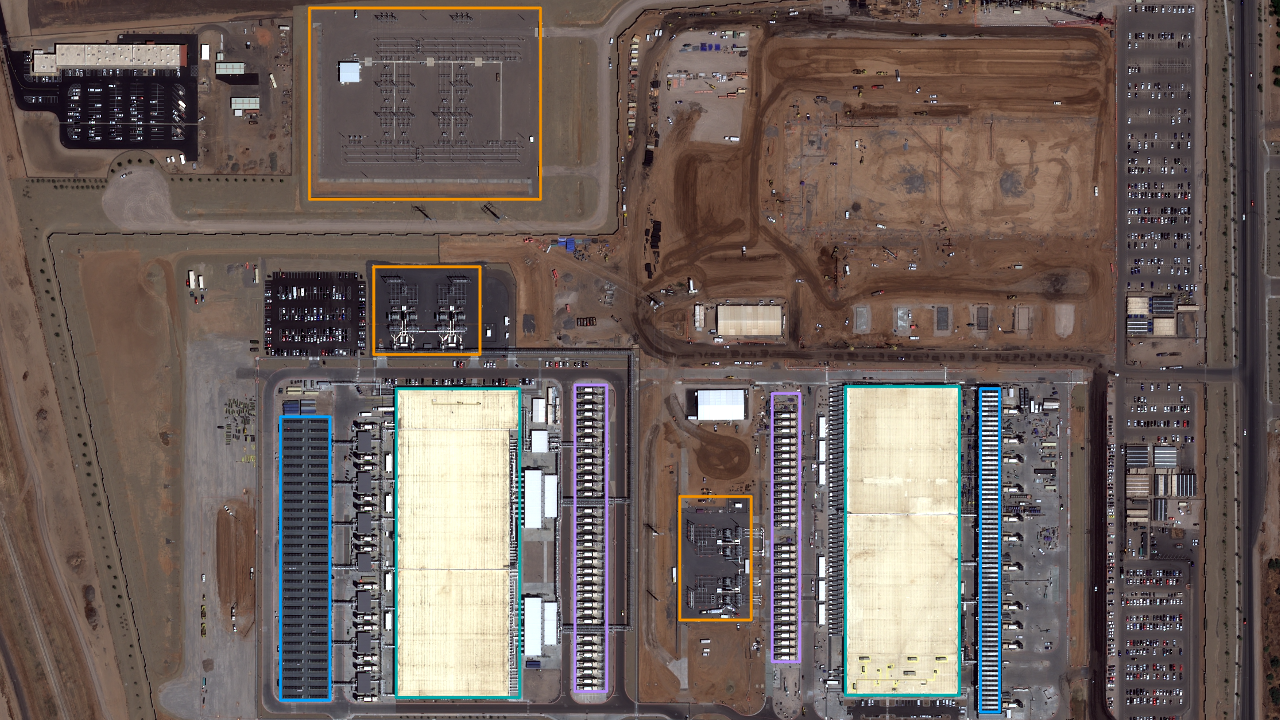

Satellite view of Google Mesa

Satellite imagery

Latest: May 16, 2026 · 2 high-res images
View satellite explorer →

Scale & specifications

CURRENT COMPUTE

126k H100-eq

2.49e20 8-bit OP/s

PROJECTED

343k H100-eq

6.79e20 8-bit OP/s

CURRENT IT POWER

90 MW

PROJECTED IT POWER

183 MW

CURRENT COST

$3.4 B

PROJECTED COST

$6.9 B

HardwareGoogle TPU v6e

CoolingAir-cooled chiller

Buildout

Jul 1, 20230K H100e
Jul 1, 2023

Land clearing begins for the entire site.

Jul 1, 2025

Building 1 is operational. This is based on the state of construction on 2025-03-02 as seen on Google Earth, where building shell and external components seems to have been completed, but there is still a lot of construction equipment present. That equipment appears to have been cleared up by this date, 4 months later, with the 2025-09-07 satellite imagery providing an upper bound. Construction has begun on the Building 2 roof, with work beginning on the areas for cooling and generators as well.

Compute
126kH100-eq
IT Power
90MW
Cost
$3.4B
Sep 7, 2025

Building 2 roof is mostly completed. Building 2's backup generators are almost complete, and cooling is a little more than halfway complete. The Building 2 substation is also under construction.

Compute
126kH100-eq
IT Power
90MW
Cost
$3.4B
May 15, 2026

Building 2 is close to being operational. There is only construction left on the backup generators, which are almost complete. Some equipment is also strewn around the building, especially near the air-cooled chillers. Preparation seems to have begun for Building 3 at the site.

Compute
126kH100-eq
IT Power
90MW
Cost
$3.4B
Aug 15, 2026

Building 2 is operational. This is estimated based on the close-to-complete construction status from May 2026.

Compute
343kH100-eq
IT Power
183MW
Cost
$6.9B

Sources

  1. DCD article on the site breaking ground
  2. DCD article on announcement to build Building 2

Read more about our methodology.
