New Albany, Ohio, United States
AWS New Albany is an operational AI data center with AI chips owned by Amazon. It hosts an estimated 201k H100-equivalents of compute, supported by 213 MW of IT power at a capital cost of $8.1 B. In Q3 2027, we project it to rise to 352k H100-eq compute, 338 MW IT power and a cost of $12.8 B. We estimate that it uses Amazon Trainium2, Nvidia H100, Nvidia H200, and Nvidia B200 chips.
The timeline of IT power and compute capacity is based on satellite imagery, regulatory filings, company disclosures, third-party reporting, and chip efficiency.
We believe this is part of the broader AWS Ohio region, potentially serving many different users. We only include the capacity taken up by leading AI chips, which we estimate to be 44%.

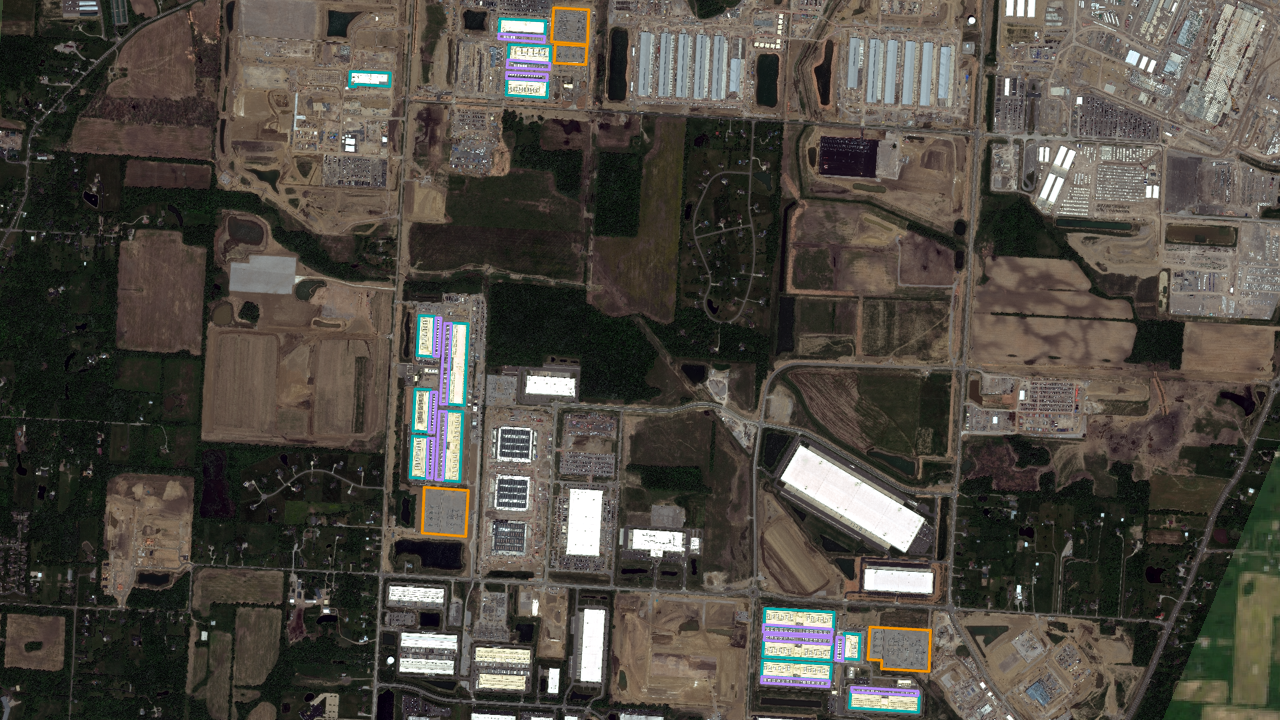

Satellite imagery
CURRENT COMPUTE
201kH100-eq
3.98e208-bit OP/s
PROJECTED
352kH100-eq
6.96e208-bit OP/s
CURRENT IT POWER
213MW
PROJECTED IT POWER
338MW
CURRENT COST
$8.1B
PROJECTED COST
$12.8B
Land clearing begins for Buildings 5-9 (eastern campus).
Buildings 5-9 (eastern campus) operational. New Albany’s Dec. 2024 report lists AWS partial occupancy for 5 buildings at the eastern campus. Note that we're only including roughly 44% of all the New Albany campuses IT Power as being dedicated to leading AI chips, based on all the types of compute instances listed. The full IT power is much higher than 113 MW.
Middle campus Buildings 10, 12, 13, and 14 appear complete/likely operational. Building 11 is still installing backup generators, so it is not counted as operational. Based on satellite imagery, northern campus Buildings 1-3 appear in late construction, with all roofs complete but nearby generator/cooling equipment still being installed for buildings 2-3. Building 4 is still early in construction. Eastern campus Buildings 5-9 appear complete and operational as expected. Note that we're only including roughly 44% of all the New Albany campuses IT Power as being dedicated to leading AI chips, based on all the types of compute instances listed.
Satellite imagery shows Building 1 in the northern campus still appears structurally finished, with no visible change from the prior two months, but we're still not counting it operational due to visible construction work around the perimeter. Buildings 2-3 still have nearby generators/cooling equipment being installed, and Building 4 is only roughly 80% roofed. Eastern campus Buildings 5-9 remain operational. Middle campus Buildings 10, 12, 13, and 14 remain operational; Building 11 is still installing backup generators and is not counted.
Expected operational date for the remaining tracked buildings (11, and 1-4) across the three campuses. This estimate is based on the previous buildings taking roughly 1.5 years from steel framing to complete operational status. Note that we're only including roughly 44% of all the New Albany campuses IT Power as being dedicated to leading AI chips, based on all the types of compute instances listed.
View our calculations for this data center, or read more about our methodology.
