Updated Jul. 15, 2026

QTS Richmond 2

Sandston, Virginia, United States

QTS Richmond 2 is an operational AI data center hosting an estimated 183k H100-equivalent chips — supported by 180 MW of IT power — at a capital cost of $6.8 B. The timeline of IT power and compute capacity is based on satellite imagery, company disclosures, regulatory filings, chip availability, and chip efficiency.

STATUS Operational
Show compute as

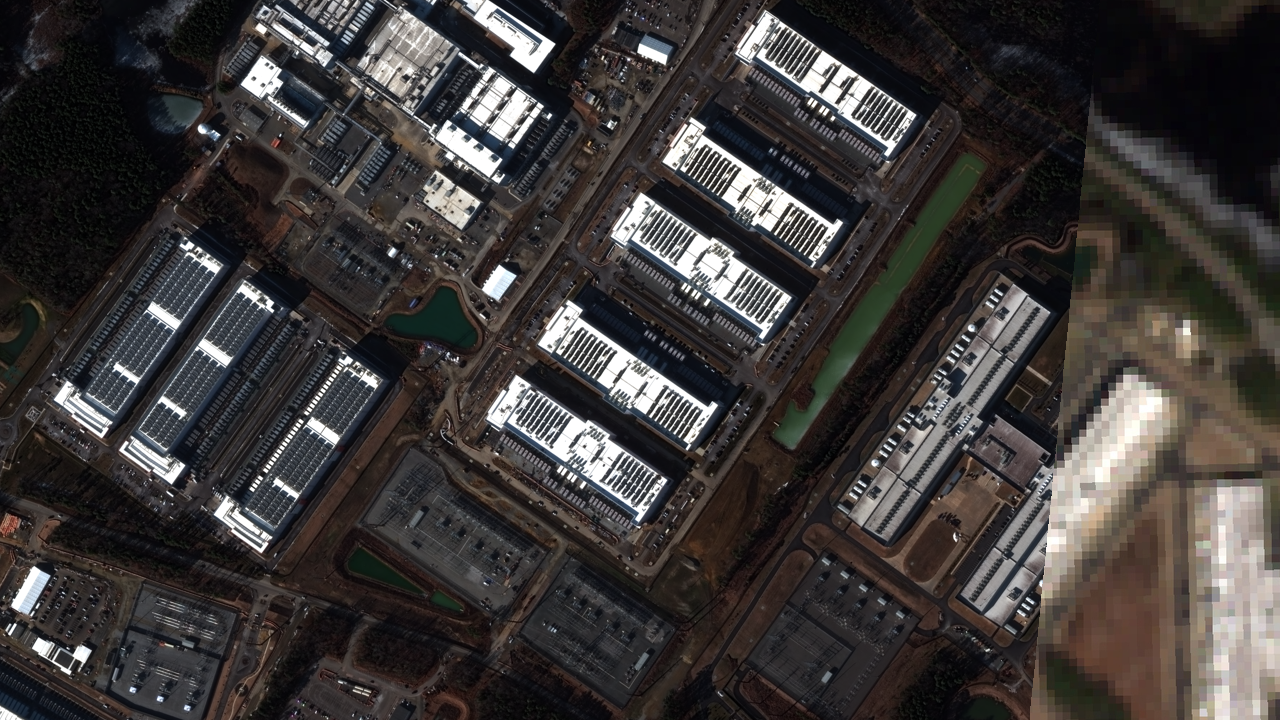

Satellite view of QTS Richmond 2

Satellite imagery

Latest: Feb. 13, 2026 · 4 high-res images
View satellite explorer →

Scale & specifications

CURRENT COMPUTE

183k H100-eq

3.62e20 8-bit OP/s

CURRENT IT POWER

180 MW

PROJECTED IT POWER

180 MW

CURRENT COST

$6.8 B

PROJECTED COST

$6.8 B

HardwareUnknown

CoolingUnknown

Buildout

Apr 1, 20220K H100e
Apr 1, 2022

Land clearing begins.

Jan 29, 2024

Building 1 and 2 look complete but we don't think they are operational, as the substation is still under construction.

Jun 23, 2024

Still not many cars parked at Building 1 and 2, and the east substation looks very close to completion, based on a Google Earth image.

Feb 4, 2025

Building 1 and 2 are operational, based on the east substation looking complete and the carparks being more full. Building 3 has cooling and generators mostly installed. Building 4 roof is partly completed.

Compute
52kH100-eq
IT Power
72MW
Cost
$2.7B
Nov 19, 2025

The west substation looks complete, based on a Google Earth image. This image also shows one corner of Building 5 that still has construction work, so it's probably not operational.

Compute
52kH100-eq
IT Power
72MW
Cost
$2.7B
Dec 31, 2025

Building 3 and 4 are operational, based on the substation being completed earlier, the buildings looking complete, and carparks being moderately full. Building 5 still has construction work.

Compute
139kH100-eq
IT Power
144MW
Cost
$5.5B
Feb 13, 2026

Building 5 still has construction work at the perimeter, but given how close it looks to completion, we estimate it's only about 3 months away from operational.

Compute
139kH100-eq
IT Power
144MW
Cost
$5.5B
May 14, 2026

Building 5 is estimated to be operational, based on the previous entry.

Compute
183kH100-eq
IT Power
180MW
Cost
$6.8B

Sources

  1. Richmond 2 factsheet
  2. Environmental permit detailing power generation

Read more about our methodology.
