Eagle Mountain, Utah, United States
QTS Eagle Mountain is an AI data center under construction with AI chips owned by and possibly used by Meta. In Q3 2027, we project it to host an estimated 347k H100-equivalents of compute, supported by 304 MW of IT power at a capital cost of $11.5 B.
The timeline of IT power and compute capacity is based on satellite imagery, our cooling equipment power model, regulatory filings, chip availability, and chip efficiency.

Satellite imagery
CURRENT COMPUTE
0H100-eq
08-bit OP/s
PROJECTED
347kH100-eq
6.87e208-bit OP/s
CURRENT IT POWER
0MW
PROJECTED IT POWER
304MW
CURRENT COST
$0.0B
PROJECTED COST
$11.5B
First signs of site preparation show up on satellite imagery.
Site preparation continues. Outline of a first building that is not the data center of interest Buildings 1 or 2 is visible.

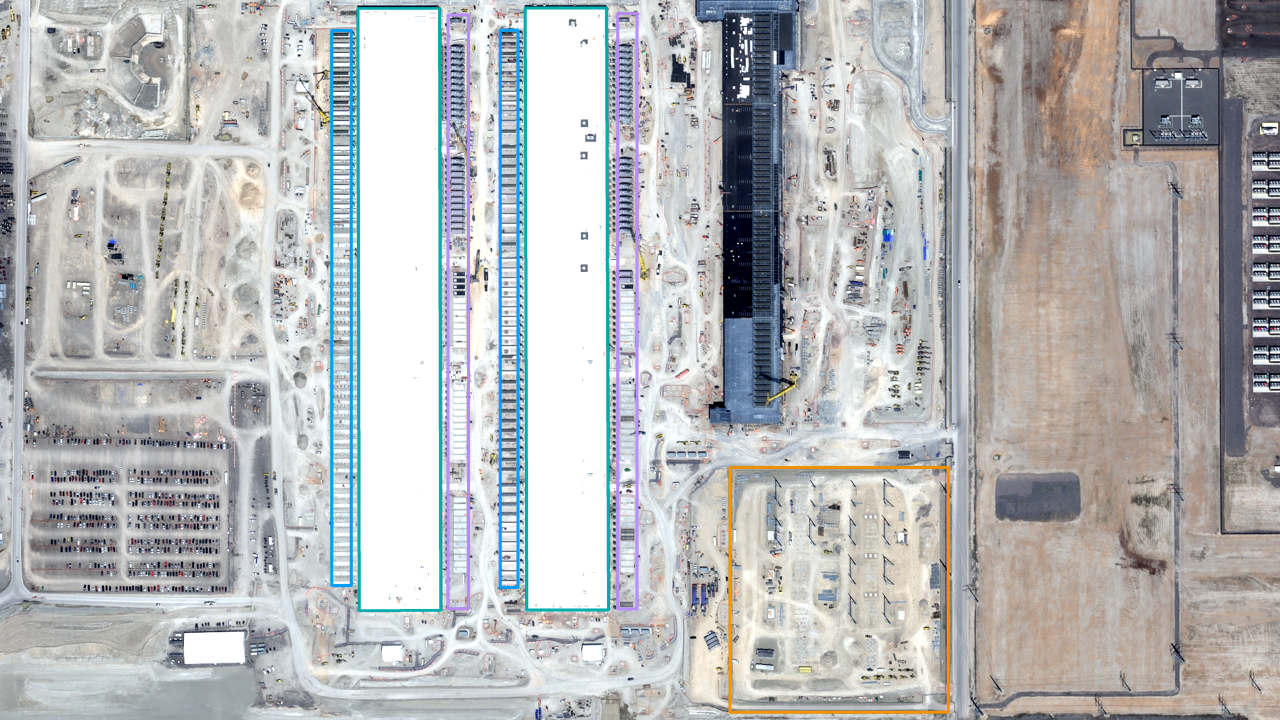

Building 1 roof finished. Satellite imagery shows construction vehicles and concrete pads with no air cooled chiller units indicating Buildings 1 and 2 cooling install continues. On the other side of each building, emergency generator install continues as well.
We estimate Buildings 1 and 2 will be fully operational by the end of 2026 because there are at least seven months since cooling and emergency generators have started to be installed. This estimate is also in line with similar QTS data center campus construction timelines.
We estimate Building 3 will be fully operational by H2 2027 following a similar time line to Buildings 1 and 2 of 14 months from land clearing to operational.
Read more about our methodology.
