Meta Prometheus

New Albany, Ohio, United States

Meta Prometheus is an operational AI data center with AI chips owned and used by Meta. It hosts an estimated 600k H100-equivalents of AI compute, supported by 496 MW of IT power at a capital cost of $18.8 B. In Q3 2028, we project it to rise to 1,235k H100-eq AI compute, 1,022 MW IT power and a cost of $38.7 B. We estimate that it uses Nvidia B200 chips.

The timeline of IT power and AI compute capacity is based on satellite imagery, our cooling equipment power model, regulatory filings, chip availability, chip efficiency, and land use maps.

Meta Prometheus is unusual for its ad hoc construction — a patchwork of weatherproof tents, colocation facilities, and traditional data center buildings spanning the full length of New Albany Business Park.

OWNERMetaSTATUSOperationalUSERMetaPROJECTPrometheus
Show compute as

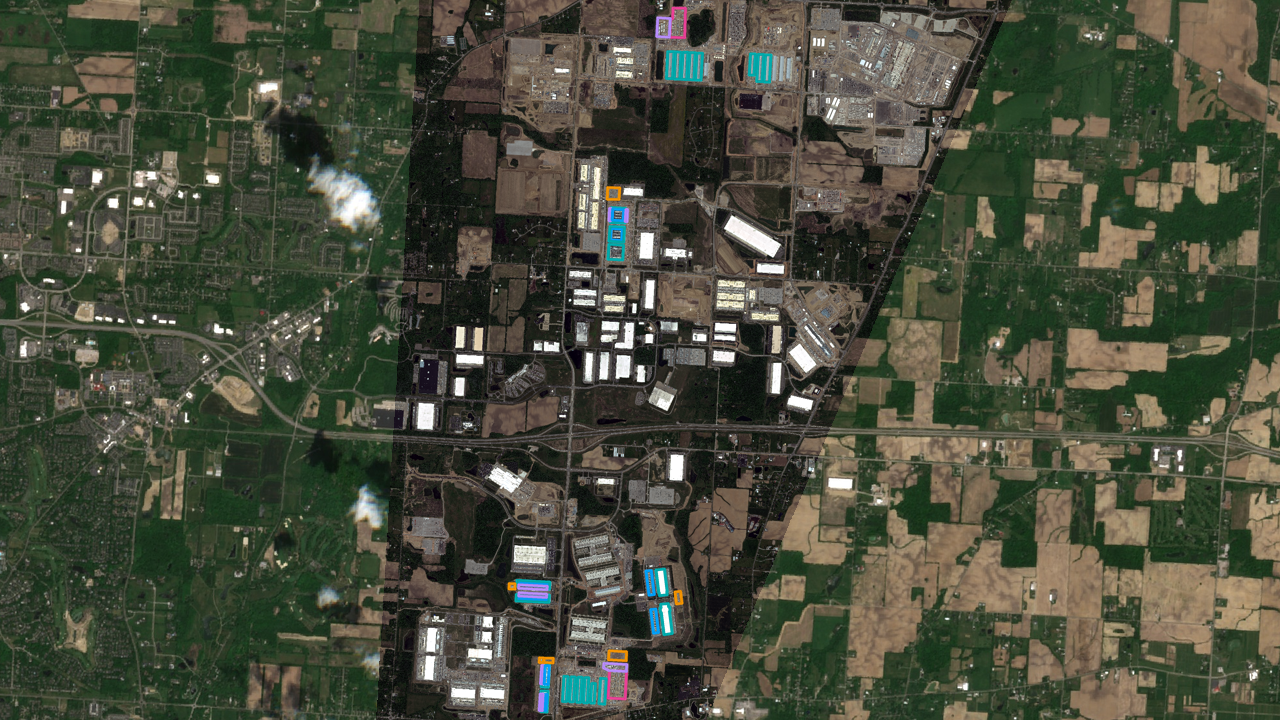

Satellite view of Meta Prometheus

Satellite imagery

Latest: Aug. 31, 2026 · 6 high-res images
View satellite explorer →

Scale & specifications

CURRENT COMPUTE

600kH100-eq

1.19e218-bit OP/s

PROJECTED

1,235kH100-eq

2.44e218-bit OP/s

CURRENT IT POWER

496MW

PROJECTED IT POWER

1,022MW

CURRENT COST

$18.8B

PROJECTED COST

$38.7B

CoolingUnknown

Buildout

Apr 14, 20220K H100e
Apr 14, 2022

Land clearing begins for Building 1-2

Jun 1, 2025

Roof complete on Building 5 (QTS-owned). In the northernmost area, land clearing begins on a new Meta site for Buildings 16-20. Building 1 still has construction work around the building and cooling equipment, so it's unlikely to be operational.

Sep 20, 2025

Building 4 operational. Based on our default estimate of roof-to-operational time.

Oct 14, 2025

Building 1 is operational, based on there being minimal construction work and cars in the main carpark. Building 2 still has some construction work around the building. Building 18 roof is complete. The on-site power at Socrates South and Socrates North has some outlines of gas turbines, to be installed later.

Compute
92kH100-eq
IT Power
76MW
Cost
$2.9B
Jan 18, 2026

Buildings 2-6 are operational, based on all equipment being in place, the paved ground, and minimal construction equipment by the buildings. Buildings 7-11 all have some kind of power or cooling equipment lining their right side which are not fully installed. Building 14 has chillers installed. Buildings 16-20 roofs are complete. The Socrates South power plant to the right of Buildings 7-11 has 7 gas turbines in place, judging by the exhaust stacks.

Compute
445kH100-eq
IT Power
368MW
Cost
$13.9B
Mar 12, 2026

The Socrates South power plant to the right of Buildings 7-11 now has 10 natural gas turbines in place, judging by the number of exhaust stacks. Battery backup has been installed nearby. To the north, a new section of tent buildings has begun east of Buildings 16-20. It is unclear how those buildings will be powered, if we assume that the Socrates North power plant is just powering Buildings 16-20.

Compute
445kH100-eq
IT Power
368MW
Cost
$13.9B
May 18, 2026

Building 7-11 (Meta tents) are operational. In January we saw them look almost complete, with some work still ongoing for power equipment. Assuming 3 more months for commissioning, we expect operation by May. Northern tents numbered 16-27 are all roofed except for 21 and 27.

Compute
600kH100-eq
IT Power
496MW
Cost
$18.8B
Aug 31, 2026

Tent buildings 16-27 look to be in a completed state. Each northern set of 6 tents still awaits to be connected to one of the corresponding power plants to become operational. Building 13 (Vantage) is still under construction, we estimate another 3 months before operability.

Compute
600kH100-eq
IT Power
496MW
Cost
$18.8B
Nov 30, 2026

Socrates South and Socrates North gas power plants are operational, enabling the operability of Buildings 12 and 16-21. This completes the 2 sets of 6 tents associated with Socrates South and Socrates North. This is based on documents stating "late Third or early Fourth Quarter of 2026", "late 2026", "November 2026", "third quarter of 2026". The timeline also lines up with RAAD drone imagery from 09/08/26 seeing operating turbines at Socrates South and a full set of turbines installed but not yet operating at Socrates North.

Compute
817kH100-eq
IT Power
676MW
Cost
$25.6B
Jan 15, 2027

Building 13 is operational, based on similar building completion timeframes by Vantage.

Compute
894kH100-eq
IT Power
740MW
Cost
$28.0B
Apr 15, 2027

Building 14 (Vantage) is operational, based on it starting construction about 3 months after Building 12.

Compute
972kH100-eq
IT Power
804MW
Cost
$30.5B
Jul 14, 2027

Building 15 (Vantage) operational, based on it starting construction about 3 months after Building 13.

Compute
1,049kH100-eq
IT Power
868MW
Cost
$32.9B
Jul 1, 2028

Buildings 22-27 (3rd set of 6 Meta tents) are operational. This is a conservative estimate to align with the operability of the Socrates the Younger power plant. The power plant is operational by Q3 of 2028 based on the project schedule. It is announced to produce a maximum of 250MW.

Compute
1,235kH100-eq
IT Power
1,022MW
Cost
$38.7B

Sources

  1. Meta blog post with details on Prometheus
  2. New Albany Business Park land use map
  3. Letter on Socrates South Power Generation Project

View our calculations for this data center, or read more about our methodology.
