Meta Aiken

Trenton, South Carolina, United States

Meta Aiken is an AI data center under construction in Trenton, SC, USA, with AI chips owned and used by Meta. No IT power is online yet; it is projected to host an estimated 162k H100-equivalent chips — supported by 142 MW — at a capital cost of $5.4 B. The timeline of IT power and compute capacity is based on satellite imagery, our cooling equipment power model, structural similarity to known buildings, chip availability, and chip efficiency. Announced in August 2024 as a more than $800 million investment, Aiken will be Meta’s 22nd U.S. data center.

OWNER Meta STATUS Under construction USER Meta
Show compute as

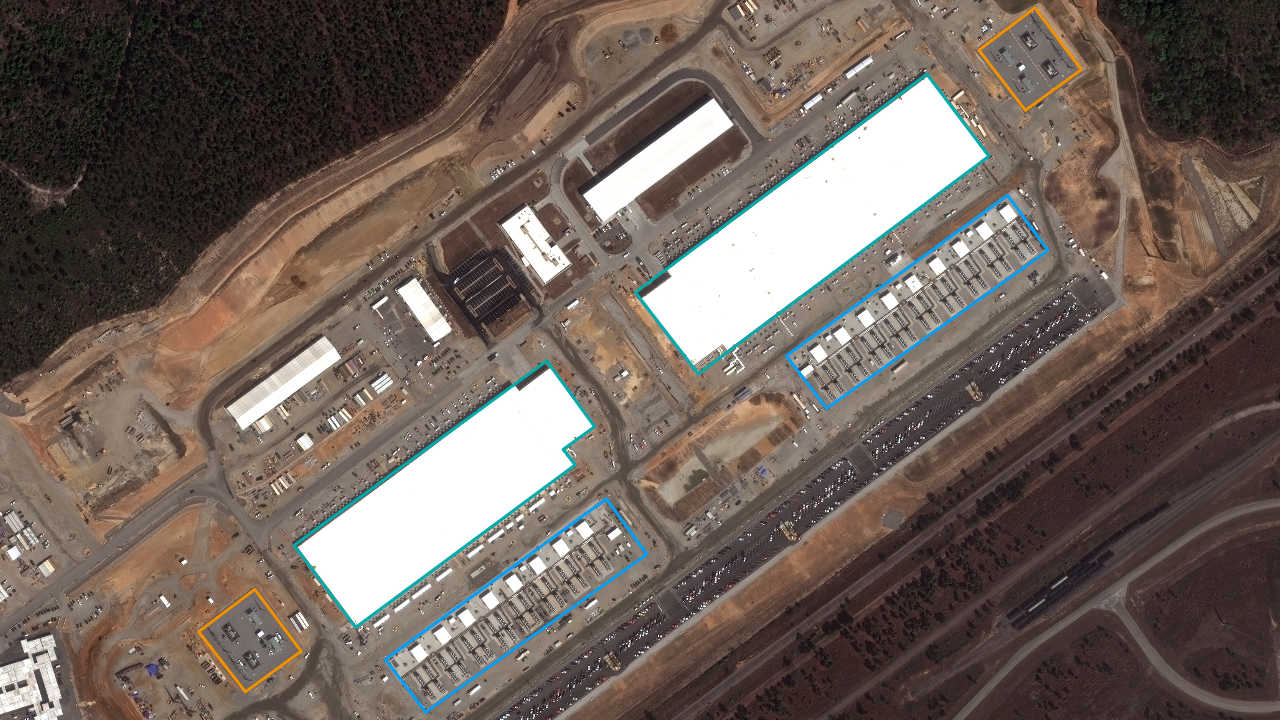

Satellite view of Meta Aiken

Satellite imagery

Latest: Apr. 10, 2026 · 1 high-res images
View satellite explorer →

Scale & specifications

CURRENT COMPUTE

0 H100-eq

0 8-bit OP/s

PROJECTED

162k H100-eq

3.20e20 8-bit OP/s

CURRENT IT POWER

0 MW

PROJECTED IT POWER

142 MW

CURRENT COST

$0.0 B

PROJECTED COST

$5.4 B

HardwareNvidia B300

CoolingUnknown

Buildout

May 30, 20240
May 30, 2024

Land clearing begins

Apr 8, 2026

Buildings 1 and 2 are nearly complete, but there's still some equipment strewn around the site. We expect 3 more months needed for commissioning and server installation.

Jul 15, 2026

Building 1 and 2 are operational (estimate).

Compute
162kH100-eq
IT Power
142MW
Cost
$5.4B

Sources

  1. Meta Introduction to the Aiken Project
  2. DPR Construction project page

Read more about our methodology.
