Google Omaha

Omaha, Nebraska, United States

Google Omaha is an operational AI data center with AI chips owned by Google and used by Google DeepMind (speculative). It hosts an estimated 268k H100-equivalents of compute, supported by 237 MW of IT power at a capital cost of $9.0 B. In Q3 2028, we project it to rise to 1,137k H100-eq compute, 395 MW IT power and a cost of $15.0 B. We estimate that it uses Google TPU v5e, Google TPU v5p, and Google TPU v6e chips.

The timeline of IT power and compute capacity is based on satellite imagery, our cooling equipment power model, regulatory filings, chip availability, and chip efficiency.

OWNER Google STATUS Operational USER Google DeepMind
Show compute as

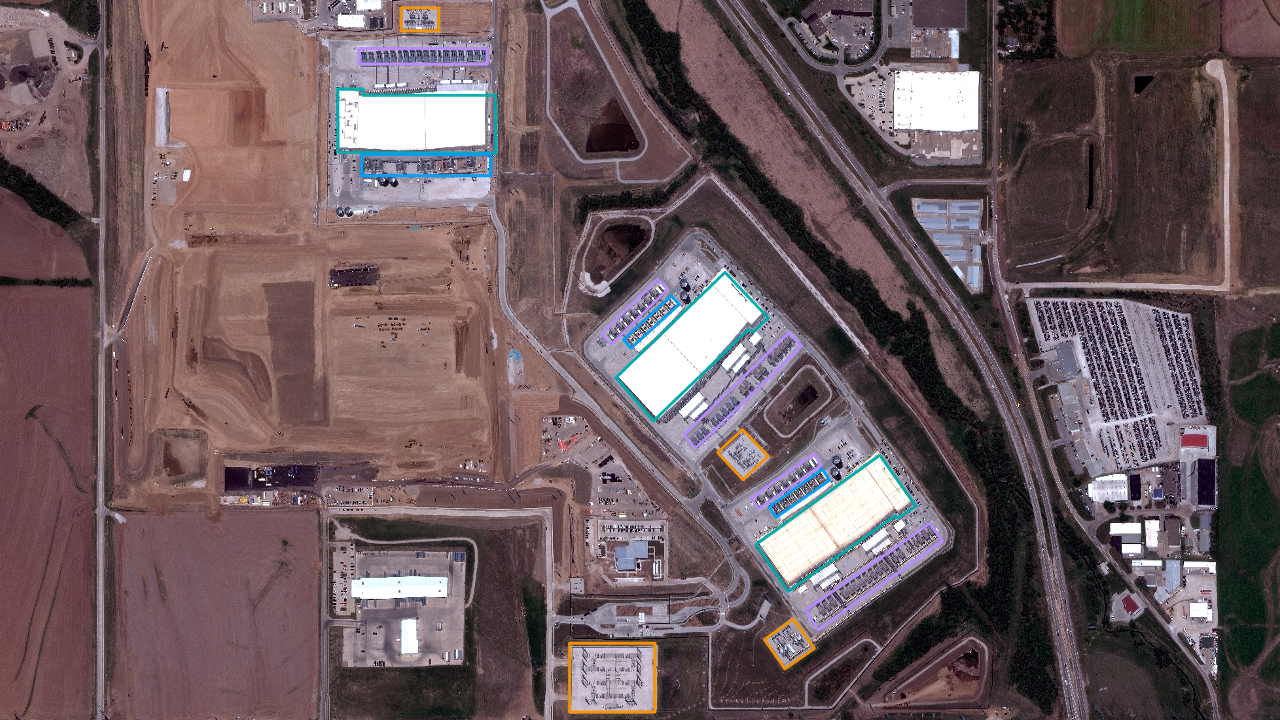

Satellite view of Google Omaha

Satellite imagery

Latest: May 13, 2026 · 5 high-res images
View satellite explorer →

Scale & specifications

CURRENT COMPUTE

268k H100-eq

5.30e20 8-bit OP/s

PROJECTED

1,137k H100-eq

2.25e21 8-bit OP/s

CURRENT IT POWER

237 MW

PROJECTED IT POWER

395 MW

CURRENT COST

$9.0 B

PROJECTED COST

$15.0 B

HardwareGoogle TPU v5e, Google TPU v5p, Google TPU v6e

CoolingEvaporative cooling tower

Buildout

Nov 25, 20210K H100e
Nov 25, 2021

Land clearing begins.

Apr 8, 2024

Building 1 operational, based on it being 6 months after roof was complete, infrastructure looked complete for 5 months.

Compute
40kH100-eq
IT Power
79MW
Cost
$3.0B
Jul 29, 2024

Building 2 has 3 cooling towers installed.

Compute
40kH100-eq
IT Power
79MW
Cost
$3.0B
Nov 19, 2024

Building 2 is operational, based on it being 8 months since the roof was complete, and surrounding infrastructure looks just completed (finishing the cooling towers).

Compute
108kH100-eq
IT Power
158MW
Cost
$6.0B
Mar 16, 2025

Confirmation that there's no obvious construction happening for Building 2. Building 3 roof started.

Compute
108kH100-eq
IT Power
158MW
Cost
$6.0B
Apr 21, 2025

Confident that Building 2 is operational

Compute
108kH100-eq
IT Power
158MW
Cost
$6.0B
Oct 21, 2025

Building 3 has all backup generators in place but they are still being installed. Two cooling towers have fans on them, with more underway. To the south of Building 3, more land has been cleared and there's a new carpark. This suggests another building will soon start construction.

Compute
108kH100-eq
IT Power
158MW
Cost
$6.0B
May 15, 2026

Building 3 appears almost complete, with only minimal construction work and equipment remaining. The cooling towers are spaced apart in an unusual way, but there's no obvious sign that more will be installed before operation. Buildings 4 and 5 haven't started construction yet, the cleared land is still empty.

Compute
108kH100-eq
IT Power
158MW
Cost
$6.0B
Jun 30, 2026

Building 3 is operational (estimate). Based on there being minimal construction work as of May 15.

Compute
268kH100-eq
IT Power
237MW
Cost
$9.0B
Jan 23, 2028

Building 4 is operational. Expect a 4th building because there's enough land cleared for it. Assuming the foundation starts at the end of May 2026 and it takes a similar time to Building 3 from foundation to operational (1 year 8 months).

Compute
642kH100-eq
IT Power
316MW
Cost
$12.0B
Jul 23, 2028

Building 5 is operational. We expect a 5th building because there's enough land cleared for one. We assume a roughly 6-month delay after Building 4.

Compute
1,137kH100-eq
IT Power
395MW
Cost
$15.0B

Sources

  1. Draft basis of air permit with details of cooling towers
