Fort Wayne, Indiana, United States
Google Fort Wayne is an AI data center under construction with AI chips owned by Google and possibly used by Google DeepMind. In Q2 2028, we project it to host an estimated 2,941k H100-equivalents of compute, supported by 863 MW of IT power at a capital cost of $32.7 B.
The timeline of IT power and compute capacity is based on satellite imagery, our cooling equipment power model, chip availability, and chip efficiency.
Fort Wayne is one of the first sites to use Google’s new, larger data center design with expanded cooling, and is projected to draw roughly 1 GW of total facility power when completed in 2028.

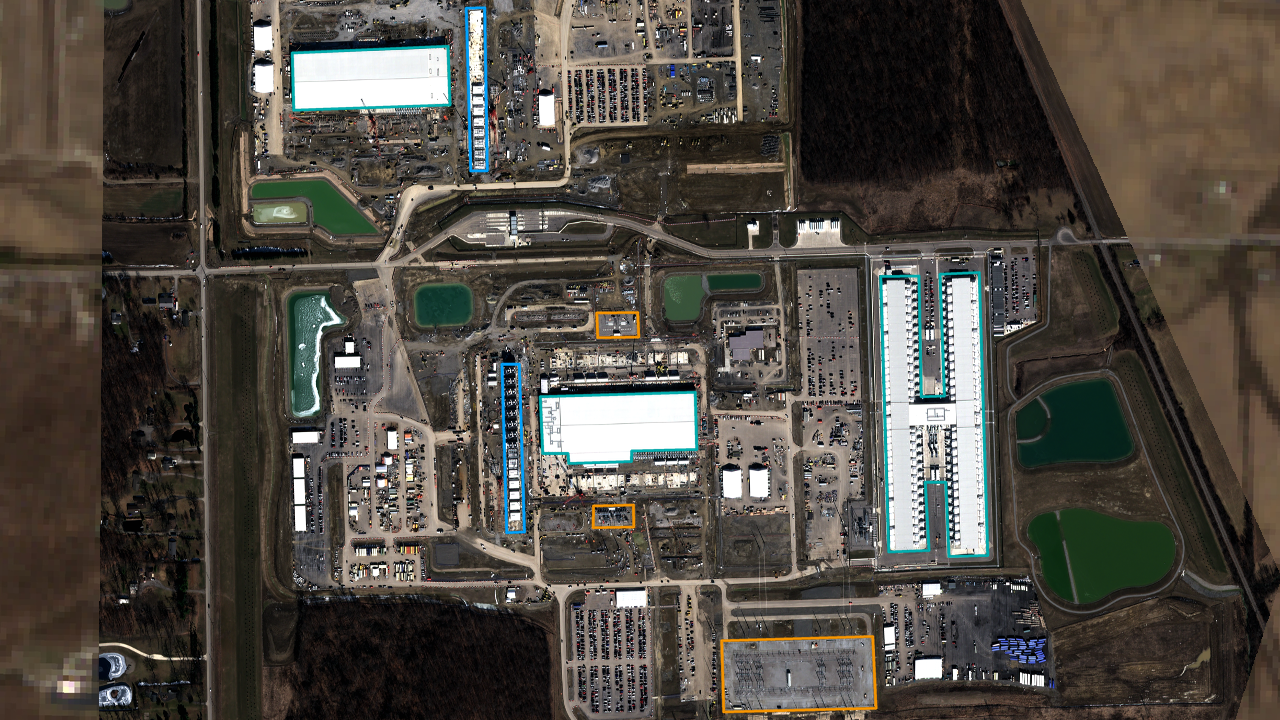

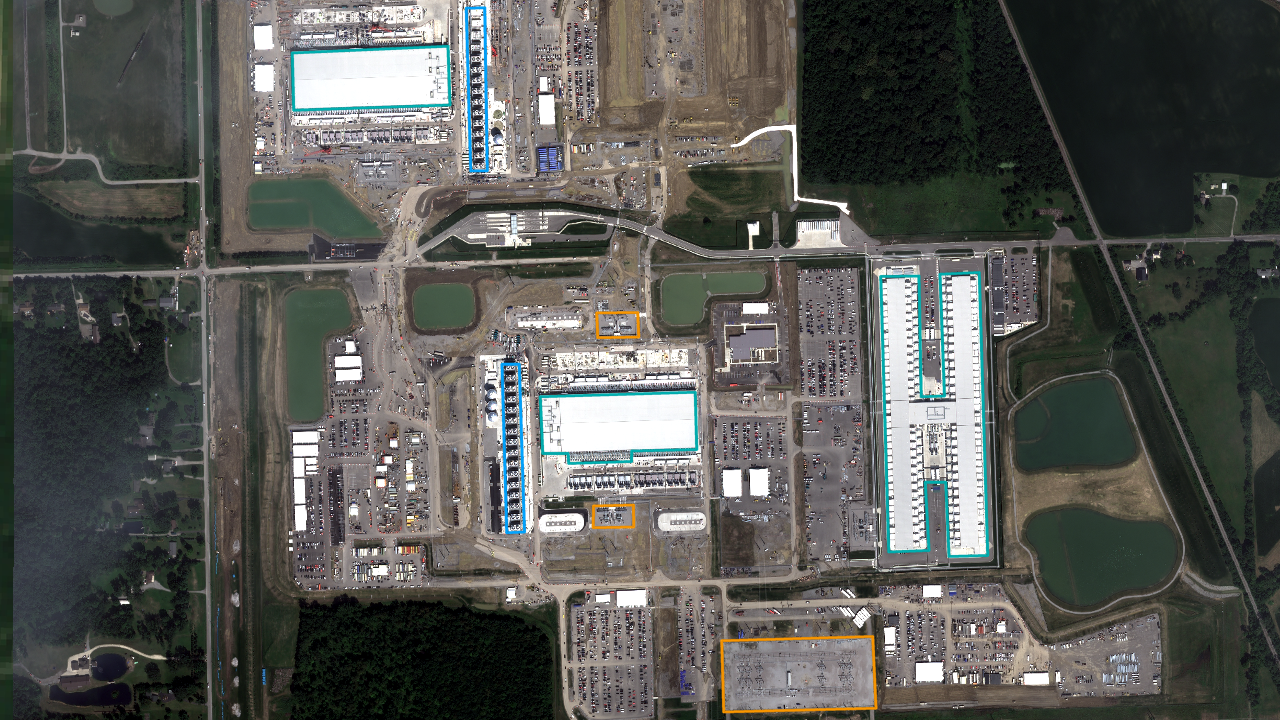

Satellite imagery
CURRENT COMPUTE
0H100-eq
08-bit OP/s
PROJECTED
2,941kH100-eq
5.82e218-bit OP/s
CURRENT IT POWER
0MW
PROJECTED IT POWER
863MW
CURRENT COST
$0.0B
PROJECTED COST
$32.7B
First signs of development/land clearing
Roof complete on Building 1 (the 'H'), although we suspect this building is not for AI compute due to the construction speed, irregular design, and lack of external cooling.
After a long quiet period they've laid foundations for Building 2 and the substation.
Building 2 looks externally complete
The cooling towers for Buildings 2 and 3 are both a little less than half done and the buildings still look like active construction sites.
Building 2 has all cooling towers installed and is likely undergoing fit-out and commissioning. So we give it about 3 more months until it's operational. Building 3 appears to be slightly further than Building 2 was in March, so we estimate a 4-month lag.
Estimated operational date of Building 2.
Estimated operational date of Building 3. Based on Building 3 construction looking about 4 months behind Building 2.
Estimated operational date of Building 4. Based on Building 4 construction looking about 10 months behind Building 2.
Estimated operational date of Building 5. Based on previous buildings being separated by about 5 months.
Estimated operational date of Building 6. Based on previous buildings being separated by about 5 months.
View our calculations for this data center, or read more about our methodology.
