Envision Galaxy Ulanqab

Ulanqab, Inner Mongolia , China

Envision Galaxy Ulanqab is an operational AI data center with an unknown chip owner. It hosts an estimated 48k H100-equivalents of AI compute, supported by 118 MW of IT power at a capital cost of $4.5 B. In Q4 2027, we project it to rise to 170k H100e AI compute, 470 MW IT power and a cost of $17.8 B. We estimate that it uses Huawei Ascend 950PR chips.

The timeline of IT power and AI compute capacity is based on satellite imagery, regulatory filings, our cooling equipment power model, chip availability, chip efficiency, and company disclosures.

Envision has stated this data center is built for large-scale model training. The first building is reportedly allocated to major Chinese tech companies, while subsequent buildings may be allocated to startups working on large model training.

STATUSOperational
Show compute as

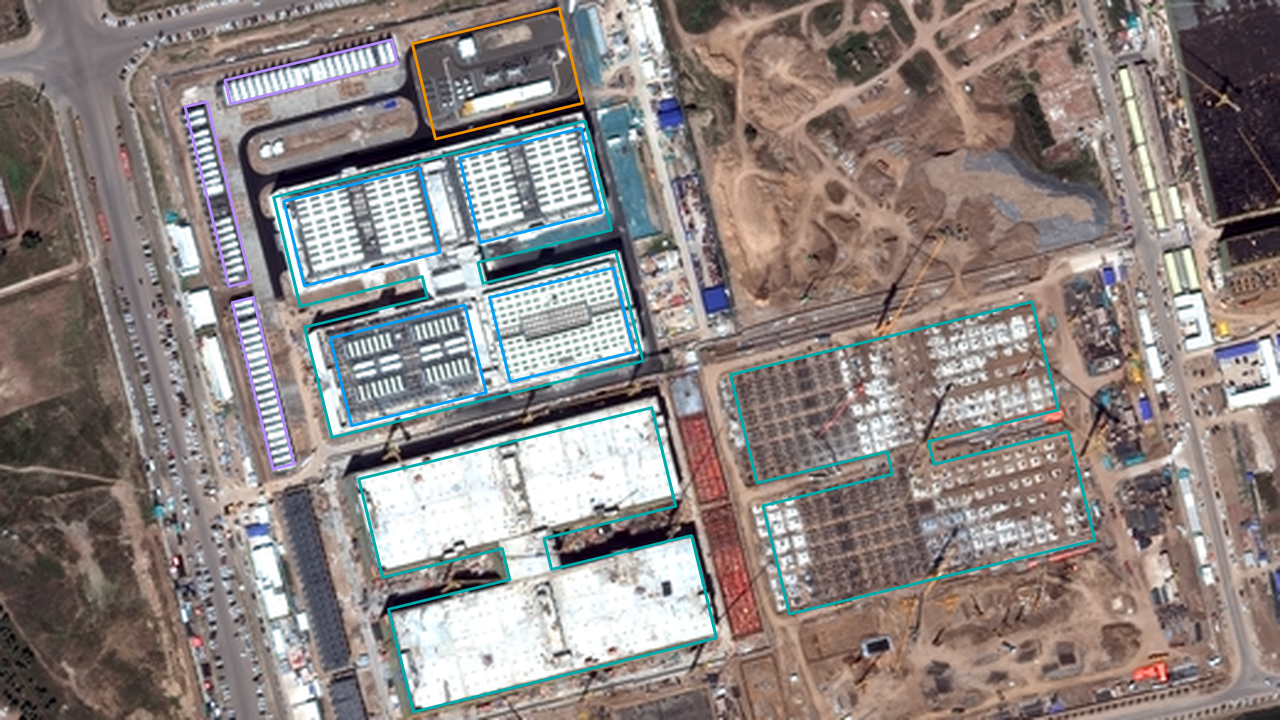

Satellite view of Envision Galaxy Ulanqab

Satellite imagery

Latest: Sep. 3, 2026 · 2 high-res images
View satellite explorer →

Scale & specifications

CURRENT COMPUTE

48kH100e

9.49e198-bit OP/s

PROJECTED

170kH100e

3.36e208-bit OP/s

CURRENT IT POWER

118MW

PROJECTED IT POWER

470MW

CURRENT COST

$4.5B

PROJECTED COST

$17.8B

Buildout

Aug 1, 20250K H100e
Aug 1, 2025

Land clearing begins for Building 1.

May 11, 2026

Building 2 is under construction.

Aug 6, 2026

Building 1 being commissioned, Building 3 under construction

Sep 5, 2026

Land clearing begins for Building 4.

Nov 1, 2026

Building 1 expected to be fully operational, assuming a 3-month fit-out period

Compute
48kH100e
IT Power
118MW
Cost
$4.5B
Jul 1, 2027

Building 2 expected to be fully operational, assuming a 3-month fitout period after taking one year from land clearing to commissioning, as demonstrated by Building 1. Similarly. Building 3 is expected to be commissioned now.

Compute
89kH100e
IT Power
235MW
Cost
$8.9B
Dec 1, 2027

Building 4 expected to be fully operational, assuming a 3-month fitout period after taking one year from land clearing to commissioning as demonstrated by Building 1.

Compute
170kH100e
IT Power
470MW
Cost
$17.8B

Sources

View our calculations for this data center, or read more about our methodology.
