Ridgeland, Mississippi, United States
Amazon Ridgeland is an operational AI data center hosting an estimated 171k H100-equivalent chips, scaling toward a projected 788k H100-equivalent chips — supported by 228 MW of IT power, rising to 840 MW — at a capital cost of $8.6 B, rising to $31.8 B. We estimate that it uses Amazon Trainium2 chips. The timeline of IT power and compute capacity is based on satellite imagery, regulatory filings, chip efficiency, and third-party reporting. This site is likely part of the Anthropic–Amazon Project Rainier collaboration.
Satellite imagery
CURRENT COMPUTE
171k H100-eq
3.39e20 8-bit OP/s
PROJECTED
788k H100-eq
1.56e21 8-bit OP/s
CURRENT IT POWER
228 MW
PROJECTED IT POWER
840 MW
CURRENT COST
$8.6 B
PROJECTED COST
$31.8 B
Land clearing begins
Roof complete on Buildings 3

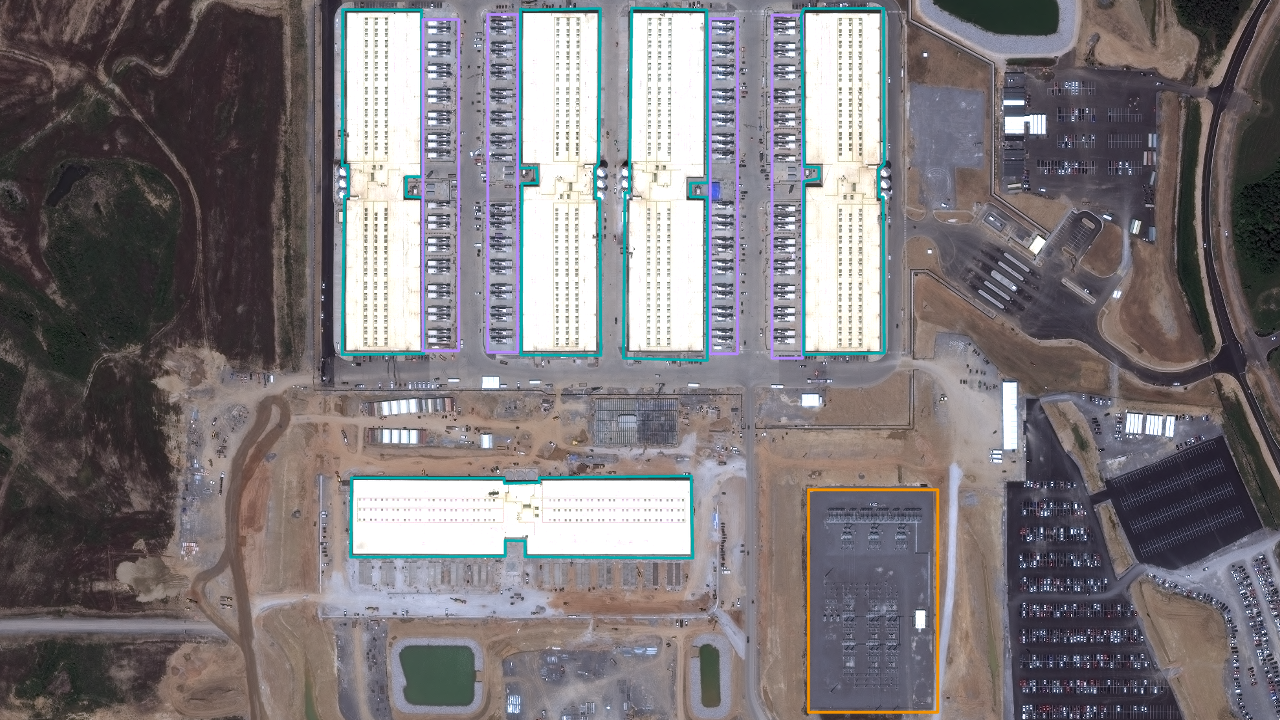

Buildings 1-4 are operational, based on the buildings shells and backup generators and most of the landscaping looking complete. Building 5 roof is complete but still lacks cooling equipment.
Building 5 is operational (estimate).
Buildings 6-14 are operational (estimate). Buildings 1-4 took an estimated 2.25 years on this site. We assume Buildings 6-14 get underway by July 2026, and take the same time as Buildings 1-4. This is later than the expected completion by 2027.
